Mina Real México

Unlocking a hidden resource.

Mina Real México SA de CV, wholly owned by Rochester Resources Ltd., holds the Mina Real and San Francisco gold and silver properties in the state of Nayarit, Mexico, east of the state capital of Tepic.

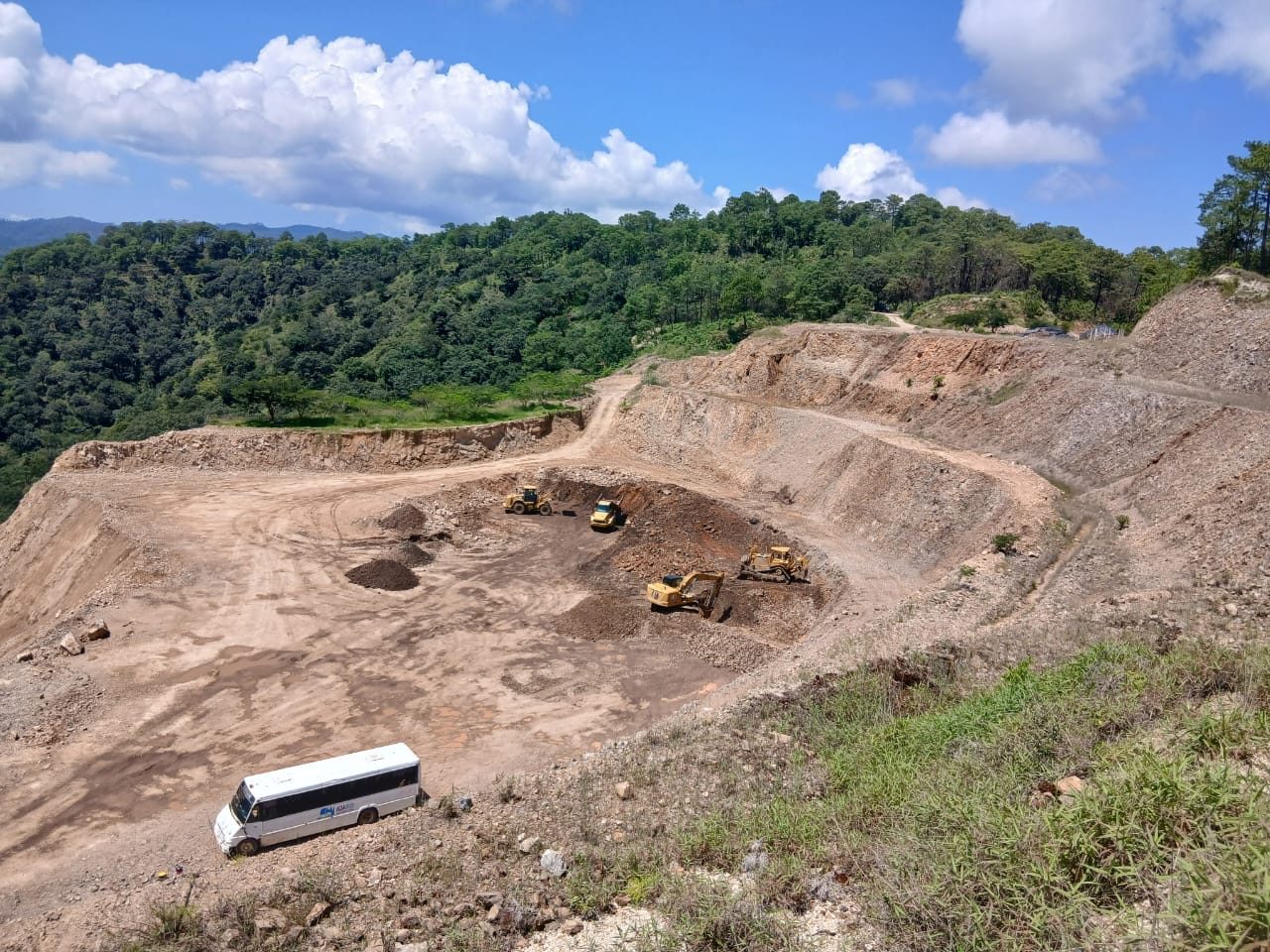

Florida NW pit
01 · Overview

Two properties in Nayarit, Mexico.

The Mina Real Property consists of 11 mining concessions and one mineral claim. The San Francisco Property consists of twelve mining concessions.

The terrain is rugged and steep, with deeply incised valleys and elevations from 800 to 1,600 metres above sea level. The climate is sub-tropical, with a dry and a wet season.

Company
Since 2007
Operating continuously in Mexico
Company
100%
Interest in Mina Real México SA de CV
Holds the Mina Real and San Francisco properties, Nayarit
Company
21,367 ha
Mina Real Property
11 mining concessions and one mineral claim (21,367.42 hectares)
Company
18,125 ha
San Francisco Property
Twelve mining concessions (18,125.05 hectares)

At present there is no Canadian Institute of Mining, Metallurgy and Petroleum (“CIM”) or National Instrument (“NI”) 43-101 compliant Resources or Reserves for the Mina Real Property or the San Francisco Property.

The Company has conducted mining operations without defined mineral resources and the production decision was not based on a feasibility study of mineral reserves that has demonstrated technical or economic viability.

A mining study to establish the technical feasibility and economic viability of the Mina Real Property has not been completed nor does the project host a mineral resource. As a result there is increased uncertainty and risk of economic and technical failure.

02 · History

Operating continuously since 2007.

  1. 2007The Mina Real processing plant begins treating mineralized material from the Estanzuela Unit.
  2. 2014Additional material from the San Francisco Unit. Today substantially all material comes from the San Francisco Unit.
  3. Q1 2024A process using certain reagents that could improve silver and gold recoveries is identified.
  4. 2024Laboratory testing with the University of Guanajuato, a three-month industrial pilot, engineering, permitting, procurement and construction of the new circuit.
  5. Oct 2024Plant modifications to increase silver recovery begin.
  6. Mar 21, 2025The new circuit commences operations.
  7. Jun–Aug 2025First phase of the plant modifications completed (fiscal Q1 2026).
  8. Oct–Dec 2025The 6′ × 5′ mill goes out of service; a used 6′ × 6′ mill is rebuilt and installed, and begins operating in late December 2025.
  9. Fiscal 2026Silver recovery of 66.70% and gold recovery of 99.60%, on 43,042 tonnes processed (year ended May 31, 2026).
  10. Oct 2026Larger pretreatment tank expected to be completed (mid to late October).

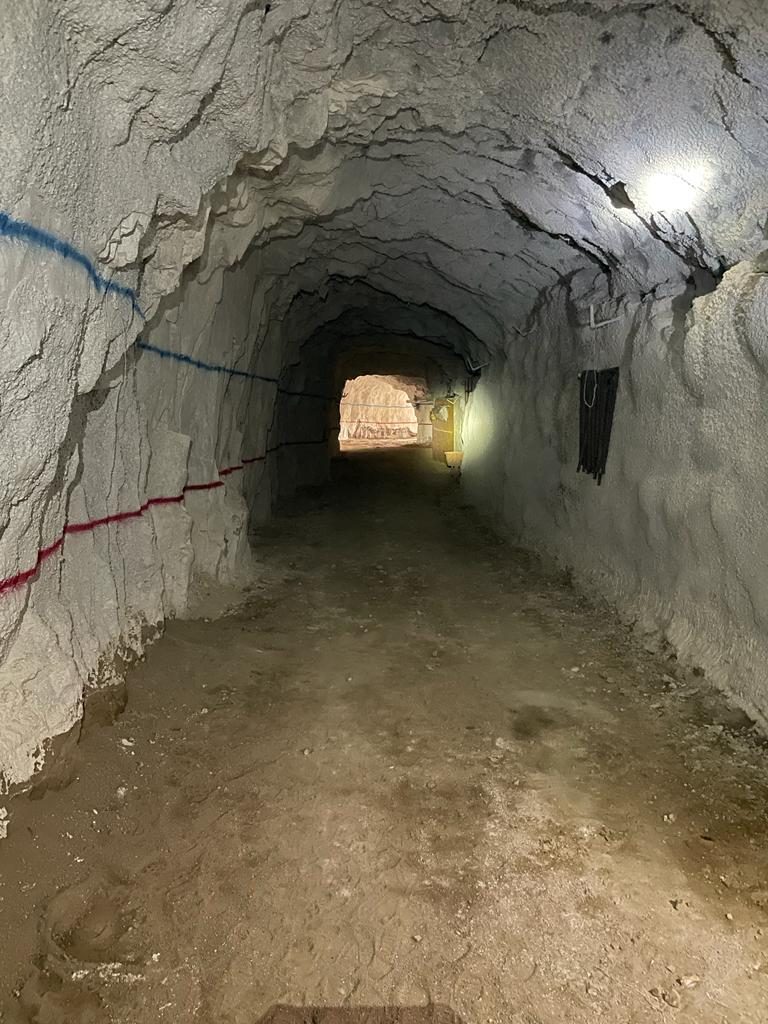

Cholita mine portal, San Francisco project
03 · The problem

Manganese kept silver out of reach.

Like many long-running silver operations, Mina Real’s mineralized material carries a naturally high manganese content.

Manganese occludes silver and interferes with conventional cyanide leaching, which has historically limited silver recovery.

Historical
~43%
Historical silver recovery baseline
Why conventional leaching fell shortIllustrative schematic. Silver grains are enclosed by manganese. Under conventional cyanidation about 4 in 10 grains are reached by the cyanide solution, in line with the historical silver recovery baseline near 43%. With the pretreatment ahead of cyanidation, about 6 in 10 are reached, in line with industrial pilot recoveries of 62% and 56%.Conventional cyanidationHistorical baseline near 43%With pretreatmentIndustrial pilot: 62% and 56%ManganeseSilver reachedSilver not reachedCyanide solution
Illustrative only, not to scale. Proportions reflect the historical baseline (~43%) and industrial pilot results (62% mine mineralized material, 56% tailings). How the pretreatment works is not shown.
04 · The opportunity

Already mined. Already crushed.

Over the many years of operation, the company has accumulated significant tonnage of mineralized material in its tailing impoundment areas.

The upgraded mill can now deal with the higher manganese content. Processing this material is a focus for fiscal 2027, and the company is working to finalize a processing plan.

05 · 2024

Research and development.

In 2024, the company focused its efforts on finding a solution to the impact of manganese on silver recoveries. A laboratory testing program, in partnership with the University of Guanajuato, evaluated mine mineralized material, tailings, and blends of both.

It identified a pretreatment combining ammonia bisulfite and sulphuric acid ahead of conventional cyanidation. The results were positive, with substantial improvements in recoveries.

Plant laboratory micro-balance for weighing gold and silver
06 · Industrial pilot

Confirmed at the plant.

A follow-up three-month industrial pilot at the plant confirmed the lab work.

Silver recovery at the plant

Historical baseline, industrial pilot and reported fiscal-year results

Historical baselineSilver recovery before the new process~43%
Industrial pilot: mine mineralized materialThree months at the plant62%
Industrial pilot: tailingsThree months at the plant56%
Fiscal 2025Reported, year ended May 31, 202552.98%
Fiscal 2026Reported, year ended May 31, 202666.70%

Fiscal-year figures are reported plant results from the MD&A for the year ended May 31, 2026. Gold recovery was 99.60% in fiscal 2026 (fiscal 2025: 96.76%). Pilot figures are from a three-month industrial pilot.

07 · Engineering

From concept to a full-scale circuit.

Building on those results, Mina Real commissioned a conceptual engineering study for a full-scale circuit.

Design capacity
500 tpd
Tailings, tons per day
Design capacity of the full-scale circuit
Design capacity
160 tpd
Fresh mineralized material, tons per day
Design capacity of the full-scale circuit
Estimate
~US$4M
Estimated capital cost
Conceptual engineering study estimate
08 · Construction

Built, then started up in March 2025.

The project moved through engineering, permitting, procurement and construction, with plant modifications beginning in October 2024. The initial phase cost approximately US$1.45 million, and the new circuit commenced operations on March 21, 2025.

Company
Mar 21, 2025
New circuit commenced operations
Plant modifications began in October 2024
Company
~US$1.45M
Initial phase of plant modifications
Approximate cost, news release March 24, 2025
09 · Plant

Plant upgrades.

With the design in place, the company carried out a comprehensive revamp of the plant.

6′ × 6′ ball mill

Ball mill · 6′ × 6′

After the 6′ × 5′ mill went out of service in October 2025, the company sourced a used 6′ × 6′ mill, rebuilt and installed it, with a corresponding slurry pump upgrade. It was commissioned and began operating in late December 2025.

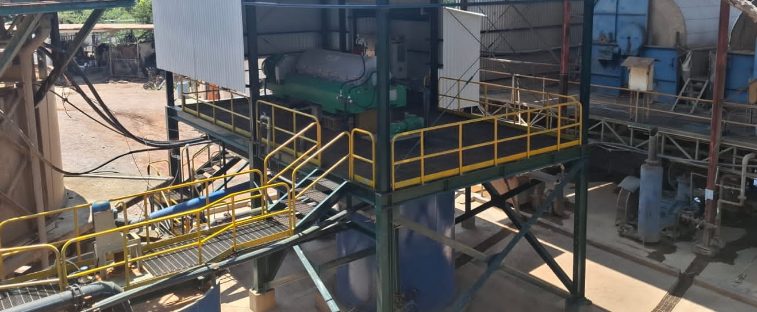

Centrifugal decanter

Centrifugal decanter

A high-speed centrifugal decanter for liquid-solid separation, installed and started up, recovers water, residual values and cyanide for reuse.

Material discharged from the centrifugal decanter

Water recovery

Water is recovered by the centrifugal decanter for reuse.

Centrifugal decanter installation

Cyanide recovery & reuse

Cyanide is recovered for reuse, cutting fresh reagent consumption.

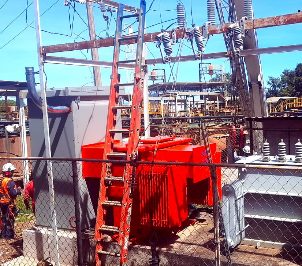

750 kVA transformer

Electrical substation

A new electrical substation, with a 750 kVA transformer and compact substation installed.

Tailings filtering station

An expanded tailings filtering station, enabling dry-stacked tailings storage.

Dry-stacked tailings

Tailings stored dry-stacked, rather than wet.

New 18,500-litre stainless-steel ammonium bisulfite tank

Stainless-steel process tanks

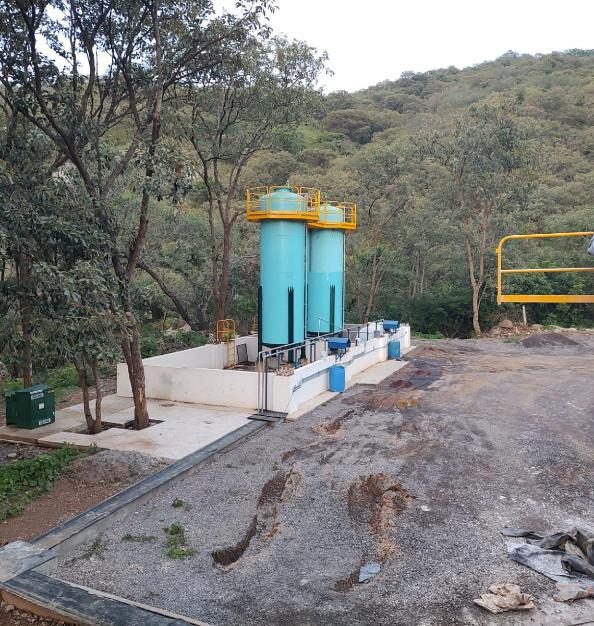

New stainless-steel process tanks, including two reagent tanks with stainless-steel piping and pumps, an acidity/basicity control tank, and a new 18,500-litre stainless-steel tank for ammonium bisulfite.

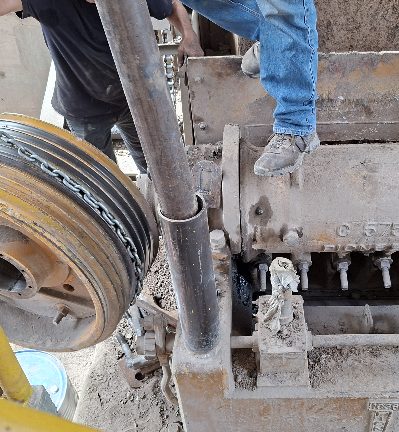

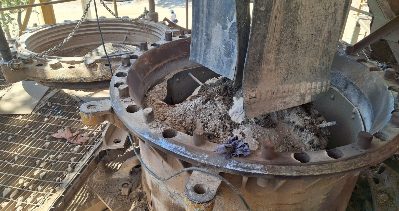

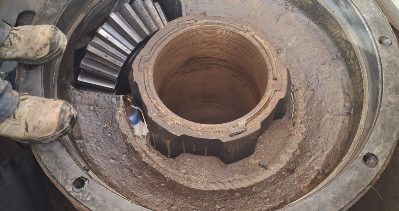

Cone crusher during repair

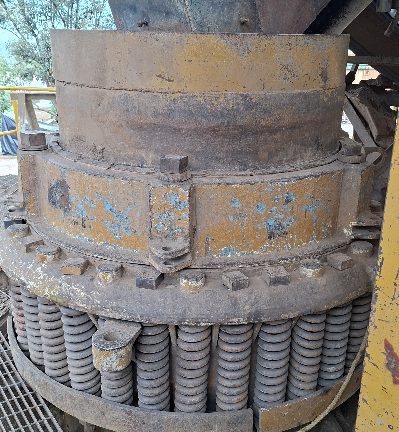

Crushing circuits

Primary, secondary and tertiary crushing circuits revamped, including repairs to the jaw crusher and the 4 ft and 3 ft cone crushers.

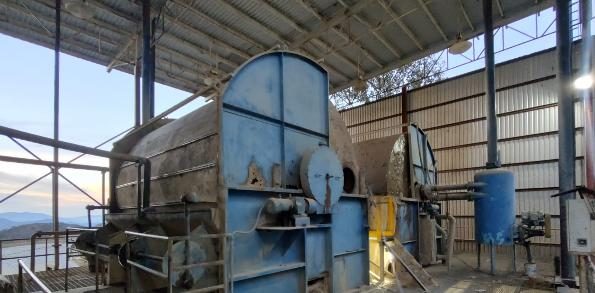

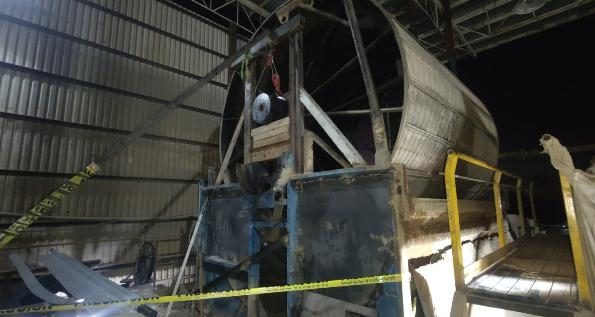

Vacuum filter no. 2, rehabilitated

Drum filters

Existing drum filters fully rehabilitated. On vacuum filter no. 2, damaged steel was replaced, filter screens changed and the filter drive rebuilt.

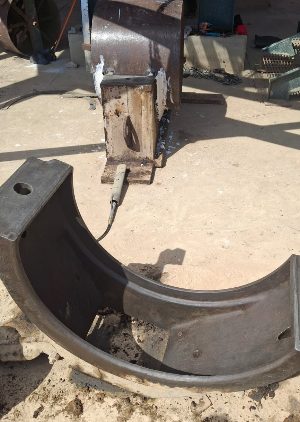

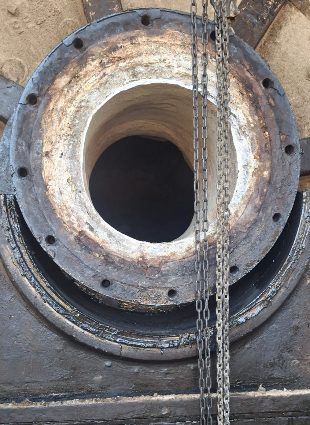

6′ × 12′ ball mill bearing work

Ball mill · 6′ × 12′

Babbitt bearing replaced on the 6′ × 12′ ball mill.

Precipitation area with new Butters filters

Precipitation

Two new Butters filters constructed for the precipitation circuit.

Laboratory micro-balance

Laboratory

A micro-balance for weighing gold and silver installed and in operation.

10 · Mine

Mine upgrades.

Loader filling a haul truck underground

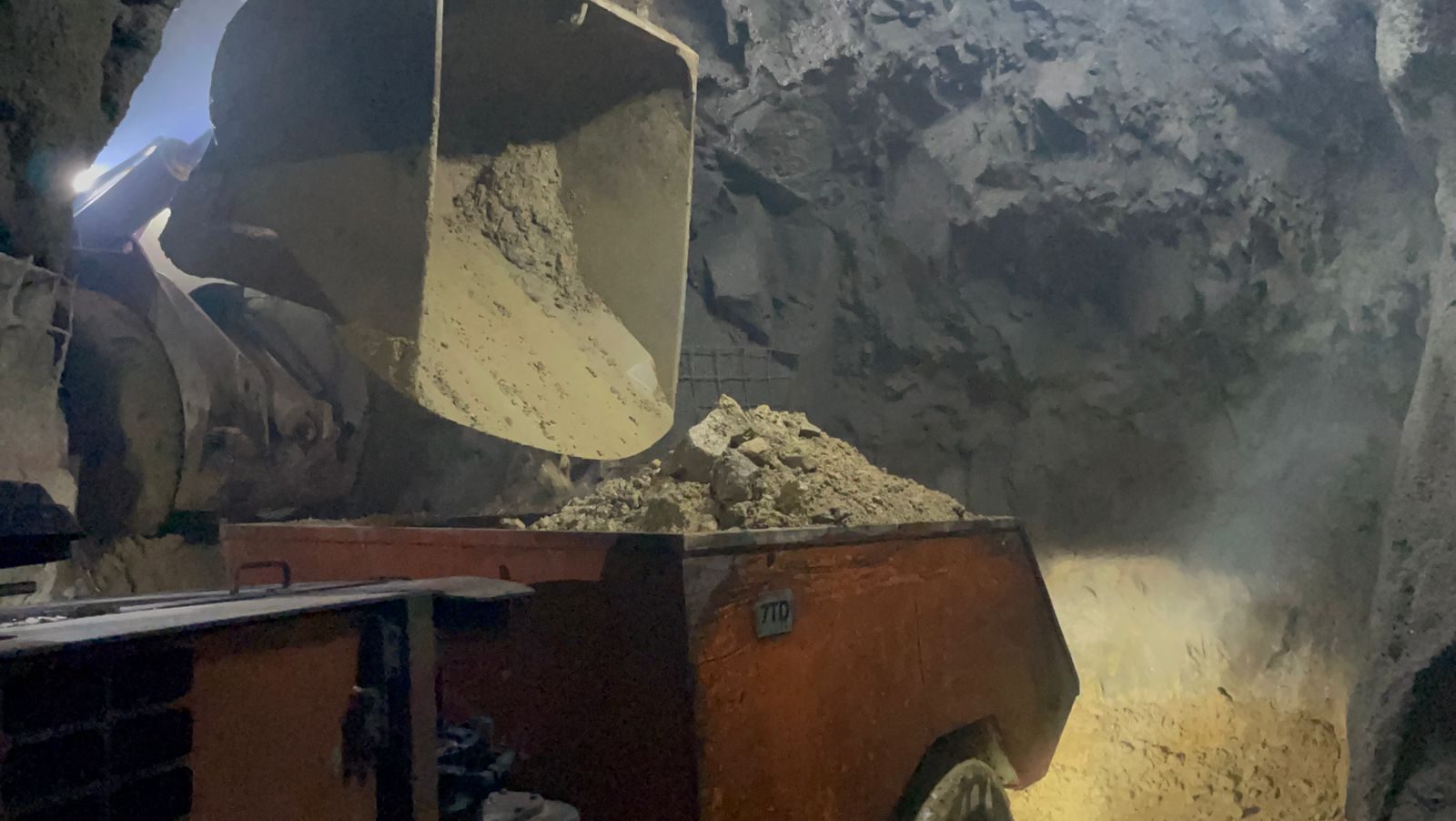

Mucking & hauling equipment

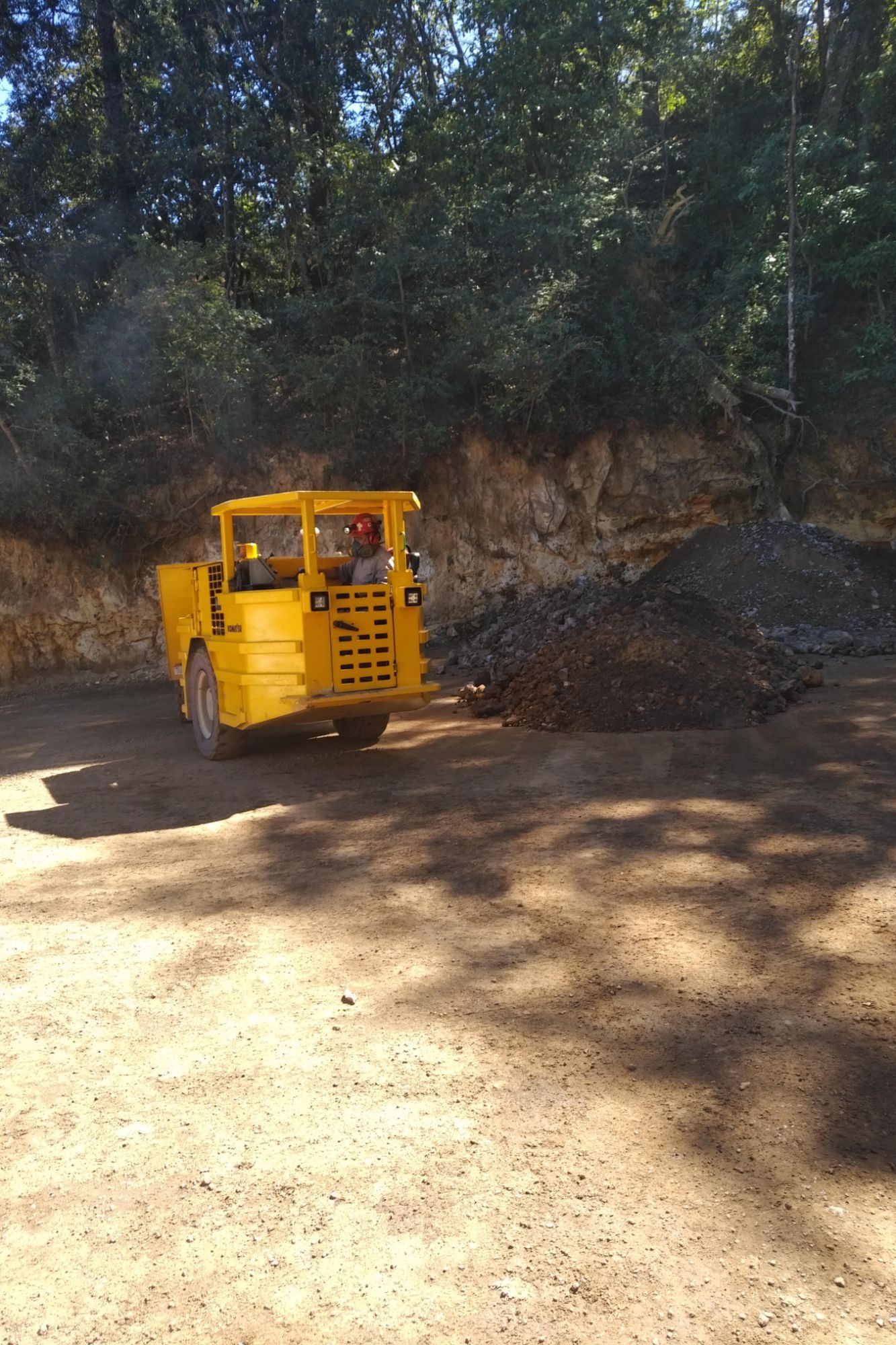

New mucking and hauling equipment brought into the mine.

Cleaning sump 018

Water pumping stations

Mine water pumping stations rehabilitated, including cleaning of sump 018.

New pump installed at sump 018

New pumps

New pumps installed, including a 40 HP pump at sump 018.

Generator and compressor area

Electrical systems

Mine electrical systems upgraded.

Compressors in the generator and compressor area

Compressed-air systems

Mine compressed-air systems upgraded.

11 · Results

Better recoveries.

Reported result
66.70%
Silver recovery, fiscal 2026
Year ended May 31, 2026. Fiscal 2025: 52.98%
Reported result
99.60%
Gold recovery, fiscal 2026
Fiscal 2025: 96.76%
Reported result
211,110 oz
Silver produced, fiscal 2026
Fiscal 2025: 166,754 oz
Reported result
4,977 oz
Gold equivalent produced, fiscal 2026
Fiscal 2025: 3,873 oz

The results have been positive, with improvements in both silver and gold recoveries. In fiscal 2026 (year ended May 31, 2026), silver recovery was 66.70%, up from 52.98% in fiscal 2025, and gold recovery was 99.60%.

Revenue rose to $25,946,223 from $13,288,820, and the company recorded operating income of $3,450,767 compared with an operating loss of $1,233,841 in fiscal 2025, aided in large part by improvement in commodity prices. The company recorded a comprehensive loss of $2,671,558 for the year, compared with $2,319,102 in fiscal 2025; the increase was primarily attributed to a fluctuation in foreign exchange.

12 · Tailings

Filtered and dry-stacked.

An expanded tailings filtering station allows tailings to be stored dry-stacked rather than wet. The dry-stacking upgrade also reduces the operation’s environmental footprint.

A centrifugal decanter recovers water, residual values and cyanide for reuse, and the water and cyanide recovery system cuts fresh reagent consumption.

13 · Next

What’s next.

The company is completing the addition of a larger pretreatment tank by mid to late October 2026, which will allow for increased capacity through the mill.

An additional mining contractor has been hired to work on the Mina Real properties, with the objective of increasing the tonnes processed. The contractor has established operations and tonnes processed are increasing.

Expected
Oct 2026
Larger pretreatment tank: expected completion
Mid to late October 2026. Expected to allow increased capacity through the mill

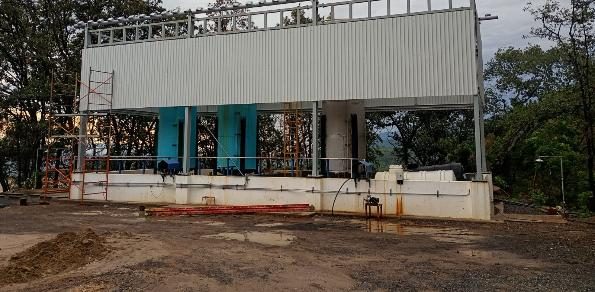

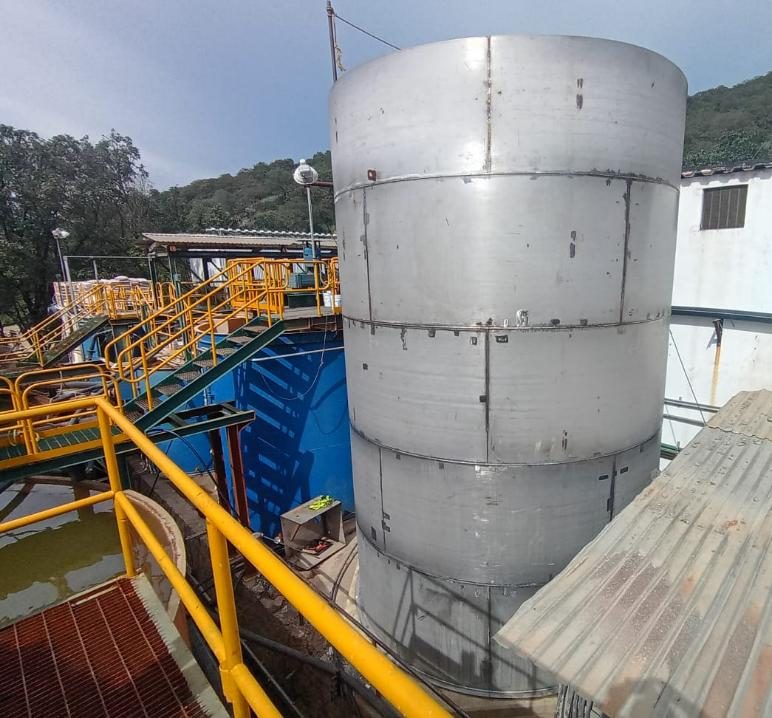

New stainless-steel pretreatment tank under construction
